King William Street Reconstruction
The District of Muskoka is reconstructing King William Street from Scott Street to Highway 60. Construction is scheduled to begin in June and is expected to be completed by the end of 2026.
The project is part of the District's investment in essential systems that make housing possible and will increase capacity to support 3,200 new homes in the Town of Huntsville.
Replacement and upgrades to aging water, wastewater and transportation infrastructure will boost housing and the economy locally and support the long-term health of Muskoka's lakes, rivers and communities.
Work will include removing and replacing:
Aboveground: road, traffic signals
Underground: sanitary and storm sewers, watermains
Streetscape: curbs, sidewalks, boulevards
As with any construction project, disruptions are to be expected, there will be impacts to the community and the District is committed to minimizing disruption wherever possible.
What You Need to Know
Traffic impacts
- Two-way traffic will be maintained through the construction area. Expect significant delays in both directions.
- One northbound lane and one southbound lane will be maintained between Scott Street and Highway 60 while construction is underway.
- Motorists should expect traffic delays and congestion in both directions and are encouraged to allow extra travel time or consider alternative routes where possible.
Access maintained
- Access to all businesses will be maintained during construction.
- Following discussions with local businesses, the traffic management plan was revised to maintain two-way access through the construction area while work progresses.
- Pedestrian crossings at Rogers Cove Drive and the Huntsville Place Mall entrance will remain open.
Updates and scheduling
Municipal 511 will be updated to help keep Google Maps and Waze current.
Delays may occur due to unforeseen conditions. Advance notice will be provided where possible.
Stay Informed
You can stay informed by:
Visiting this page regularly for updates
Attending a Construction Café (dates will be shared on this page and to those who've subscribed for updates.)
Subscribing to project updates (enter in your email address at the top right side of this page)
We recognize construction can be disruptive for residents, motorists and businesses and thank you for your patience during this important project.
The District of Muskoka is reconstructing King William Street from Scott Street to Highway 60. Construction is scheduled to begin in June and is expected to be completed by the end of 2026.
The project is part of the District's investment in essential systems that make housing possible and will increase capacity to support 3,200 new homes in the Town of Huntsville.
Replacement and upgrades to aging water, wastewater and transportation infrastructure will boost housing and the economy locally and support the long-term health of Muskoka's lakes, rivers and communities.
Work will include removing and replacing:
Aboveground: road, traffic signals
Underground: sanitary and storm sewers, watermains
Streetscape: curbs, sidewalks, boulevards
As with any construction project, disruptions are to be expected, there will be impacts to the community and the District is committed to minimizing disruption wherever possible.
What You Need to Know
Traffic impacts
- Two-way traffic will be maintained through the construction area. Expect significant delays in both directions.
- One northbound lane and one southbound lane will be maintained between Scott Street and Highway 60 while construction is underway.
- Motorists should expect traffic delays and congestion in both directions and are encouraged to allow extra travel time or consider alternative routes where possible.
Access maintained
- Access to all businesses will be maintained during construction.
- Following discussions with local businesses, the traffic management plan was revised to maintain two-way access through the construction area while work progresses.
- Pedestrian crossings at Rogers Cove Drive and the Huntsville Place Mall entrance will remain open.
Updates and scheduling
Municipal 511 will be updated to help keep Google Maps and Waze current.
Delays may occur due to unforeseen conditions. Advance notice will be provided where possible.
Stay Informed
You can stay informed by:
Visiting this page regularly for updates
Attending a Construction Café (dates will be shared on this page and to those who've subscribed for updates.)
Subscribing to project updates (enter in your email address at the top right side of this page)
We recognize construction can be disruptive for residents, motorists and businesses and thank you for your patience during this important project.
-
August 3 Project Update
Share August 3 Project Update on Facebook Share August 3 Project Update on X (formerly Twitter) Share August 3 Project Update on Linkedin Email August 3 Project Update linkWork planned week of August 4 to August 7
Crews work to place a structure base and dewater the work area. - Work planned includes:
- Sanitary pipe installations continuing south of Rogers Cove.
- Water line upgrades continue south of Rogers Cove.
- Installation of forcemain pipe (a pressurized pipe that carries wastewater. to the treatment plant) continues south of Rogers Cove.
- Storm sewer (rainwater pipe) installation continues north of Rogers Cove.
- Road reconstruction continues on northbound King William Street.
Work completed week of July 27 to July 31
- Crews installed new sanitary underground pipes, repaired existing sewer lines, and continued installing new piping.
- Sanitary sewer maintenance hole completed south of Rogers Cove.
Community impacts
- Crews will work Friday, August 7 in lieu of Monday, August 3.
- Traffic patterns may change the week of August 3 to 7, with a lane switch over to accommodate watermain installation, storm sewer installations and road base rehabilitation.
- Please watch for signage and reduce speed through the work zone.
Work planned week of August 4 to August 7
Crews work to place a structure base and dewater the work area. - Work planned includes:
- Sanitary pipe installations continuing south of Rogers Cove.
- Water line upgrades continue south of Rogers Cove.
- Installation of forcemain pipe (a pressurized pipe that carries wastewater. to the treatment plant) continues south of Rogers Cove.
- Storm sewer (rainwater pipe) installation continues north of Rogers Cove.
- Road reconstruction continues on northbound King William Street.
Work completed week of July 27 to July 31
- Crews installed new sanitary underground pipes, repaired existing sewer lines, and continued installing new piping.
- Sanitary sewer maintenance hole completed south of Rogers Cove.
Community impacts
- Crews will work Friday, August 7 in lieu of Monday, August 3.
- Traffic patterns may change the week of August 3 to 7, with a lane switch over to accommodate watermain installation, storm sewer installations and road base rehabilitation.
- Please watch for signage and reduce speed through the work zone.
- Work planned includes:
-
July 27 Project Update
Share July 27 Project Update on Facebook Share July 27 Project Update on X (formerly Twitter) Share July 27 Project Update on Linkedin Email July 27 Project Update linkWork planned week of July 27 to July 31
- Crews will continue installing the new sanitary sewer.
- Crews will begin forcemain installation.
Work completed week of July 20 to July 24
- Crews continued installation of the new sanitary sewer.
- A water valve was successfully installed at the north limit of the project using insertion
Manhole being installed. valve technology, allowing the work to be completed without shutting down the watermain. - Crews completed a watermain cut-and-cap operation, enabling the next phase of watermain replacement work to begin.
Community impacts
- Portable Variable Message Signs (PVMS) have been deployed to display real-time travel times through the construction zone, helping motorists make informed routing decisions.
- Drivers are reminded to follow all posted traffic control signage and keep intersections clear to maintain safe and efficient traffic flow through the work area.
- All businesses within the construction zone remain open and accessible to customers.
Work planned week of July 27 to July 31
- Crews will continue installing the new sanitary sewer.
- Crews will begin forcemain installation.
Work completed week of July 20 to July 24
- Crews continued installation of the new sanitary sewer.
- A water valve was successfully installed at the north limit of the project using insertion
Manhole being installed. valve technology, allowing the work to be completed without shutting down the watermain. - Crews completed a watermain cut-and-cap operation, enabling the next phase of watermain replacement work to begin.
Community impacts
- Portable Variable Message Signs (PVMS) have been deployed to display real-time travel times through the construction zone, helping motorists make informed routing decisions.
- Drivers are reminded to follow all posted traffic control signage and keep intersections clear to maintain safe and efficient traffic flow through the work area.
- All businesses within the construction zone remain open and accessible to customers.
-
July 20 Project Update
Share July 20 Project Update on Facebook Share July 20 Project Update on X (formerly Twitter) Share July 20 Project Update on Linkedin Email July 20 Project Update linkWork planned Week of July 20 to 24
- Crews to continue work on the replacement of the sanitary sewer system
Rock breaking work underway.
Work completed Week of July 12 to 17
- Crews excavated deep sanitary maintenance holes and replaced a section of sanitary sewer pipe using a method that avoids excavating
- Crews completed nighttime watermain isolation work in preparation for watermain replacement
- Safety measures like barriers, warning signs, and metal road plates were used to protect drivers and pedestrians.
Community impacts
- Businesses in the construction zone remain open and fully accessible to customers, with one lane open in each direction drivers should expect delays and plan for additional travel time.
- When travelling through the area, please follow all posted signs, use caution, and keep intersections clear. Your patience helps keep workers, drivers, and pedestrians safe.
Work planned Week of July 20 to 24
- Crews to continue work on the replacement of the sanitary sewer system
Rock breaking work underway.
Work completed Week of July 12 to 17
- Crews excavated deep sanitary maintenance holes and replaced a section of sanitary sewer pipe using a method that avoids excavating
- Crews completed nighttime watermain isolation work in preparation for watermain replacement
- Safety measures like barriers, warning signs, and metal road plates were used to protect drivers and pedestrians.
Community impacts
- Businesses in the construction zone remain open and fully accessible to customers, with one lane open in each direction drivers should expect delays and plan for additional travel time.
- When travelling through the area, please follow all posted signs, use caution, and keep intersections clear. Your patience helps keep workers, drivers, and pedestrians safe.
- Crews to continue work on the replacement of the sanitary sewer system
-
July 10, 2026 Project Update
Share July 10, 2026 Project Update on Facebook Share July 10, 2026 Project Update on X (formerly Twitter) Share July 10, 2026 Project Update on Linkedin Email July 10, 2026 Project Update linkWork planned Week of July 13 to July 17
- Sanitary sewer pipe replacement will continue using trenchless methods, a construction technique that minimizes excavation and reduces disruption to the street.
- Water service will be temporarily interrupted while the existing watermain is isolated from the distribution network. To minimize impacts on local businesses, this work is scheduled to occur overnight. The contractor has been working closely with affected businesses to coordinate the interruption and provide advance notice.
Work completed Week of July 6 to July 10
- Temporary sanitary by-pass system was setup and tested to maintain sanitary sewer
service throughout construction.
New sewer infrastructure being installed. - Crews excavated and installed a new sanitary maintenance hole at the north limit
of the project.
Community impacts
- Businesses in the construction zone remain open and fully accessible to
customers, with one lane open in each direction drivers should expect delays and plan for additional travel time. - To help keep local businesses running smoothly, some construction specific to water operations will take place overnight beginning on Sunday, July 12 to Thursday, July 16:
- Working 24 hours a day means water service switchovers will be done faster, limiting impacts to day-to-day operations.
- If your business may be affected by a temporary water interruption, you’ll receive advance notice to help plan ahead.
- Drivers are reminded to follow all posted traffic signs and keep intersections clear to help maintain safe traffic flow through the construction zone.
Work planned Week of July 13 to July 17
- Sanitary sewer pipe replacement will continue using trenchless methods, a construction technique that minimizes excavation and reduces disruption to the street.
- Water service will be temporarily interrupted while the existing watermain is isolated from the distribution network. To minimize impacts on local businesses, this work is scheduled to occur overnight. The contractor has been working closely with affected businesses to coordinate the interruption and provide advance notice.
Work completed Week of July 6 to July 10
- Temporary sanitary by-pass system was setup and tested to maintain sanitary sewer
service throughout construction.
New sewer infrastructure being installed. - Crews excavated and installed a new sanitary maintenance hole at the north limit
of the project.
Community impacts
- Businesses in the construction zone remain open and fully accessible to
customers, with one lane open in each direction drivers should expect delays and plan for additional travel time. - To help keep local businesses running smoothly, some construction specific to water operations will take place overnight beginning on Sunday, July 12 to Thursday, July 16:
- Working 24 hours a day means water service switchovers will be done faster, limiting impacts to day-to-day operations.
- If your business may be affected by a temporary water interruption, you’ll receive advance notice to help plan ahead.
- Drivers are reminded to follow all posted traffic signs and keep intersections clear to help maintain safe traffic flow through the construction zone.
-
July 6, 2026 Project Update
Share July 6, 2026 Project Update on Facebook Share July 6, 2026 Project Update on X (formerly Twitter) Share July 6, 2026 Project Update on Linkedin Email July 6, 2026 Project Update linkWork planned week of July 6 to July 10
- Contractor will finish setup and testing of temporary sanitary bypass system.
- Excavation at the north limit of the project will begin for new maintenance hole installation.
- Work will begin to replace existing sanitary sewer pipes using trenchless methods.
Work completed week of June 29 to July 3
- Multiple businesses were successfully connected to the temporary water system following approved water‑quality testing.
- Crews began installing the temporary bypass system required ahead of upcoming sewer work.
- Dust control, site fencing, pedestrian access improvements, and pothole repairs were completed to maintain safe movement of vehicles and pedestrians through the construction zone.
Community impacts
- Businesses in the construction zone remain open and fully accessible to customers.
- One lane remains open in each direction. Drivers should expect delays and plan for additional travel time.
- Traffic conditions are being monitored and adjustments made as needed.
Work planned week of July 6 to July 10
- Contractor will finish setup and testing of temporary sanitary bypass system.
- Excavation at the north limit of the project will begin for new maintenance hole installation.
- Work will begin to replace existing sanitary sewer pipes using trenchless methods.
Work completed week of June 29 to July 3
- Multiple businesses were successfully connected to the temporary water system following approved water‑quality testing.
- Crews began installing the temporary bypass system required ahead of upcoming sewer work.
- Dust control, site fencing, pedestrian access improvements, and pothole repairs were completed to maintain safe movement of vehicles and pedestrians through the construction zone.
Community impacts
- Businesses in the construction zone remain open and fully accessible to customers.
- One lane remains open in each direction. Drivers should expect delays and plan for additional travel time.
- Traffic conditions are being monitored and adjustments made as needed.
-
June 29, 2026 Project Update
Share June 29, 2026 Project Update on Facebook Share June 29, 2026 Project Update on X (formerly Twitter) Share June 29, 2026 Project Update on Linkedin Email June 29, 2026 Project Update linkWork planned week of June 29 to July 3
- Once water quality testing is complete, crews will begin switching water services to the temporary water supply. Water interruption notices were delivered to affected businesses on June 25, 2026.
- Excavations will begin in the north section of the project area to prepare for underground pipe replacement.
- A temporary sewer bypass system will be installed to maintain sanitary sewer service while sanitary sewer is replaced.
Work completed week of June 22 to June 26- Progress & safety: Crews located utilities, began testing the temporary watermain, and installed safety fencing to protect pedestrians and drivers.
- Road conditions: Potholes were repaired, the road was regraded, and recycled asphalt was added to improve driving through the zone.
- Traffic management: Signal timing was actively monitored and adjusted with MTO to maintain traffic flow.
Community impacts
- Access & traffic: Businesses remain open and accessible; one lane each direction is maintained, but delays are expected—plan extra travel time.
- Monitoring & scheduling: Traffic signals are being monitored/adjusted, and construction (including Canada Day work) continues to stay on schedule.
- Water service updates: Some businesses will have temporary water interruptions; notices have been delivered and the contractor will communicate directly with those affected.
Work planned week of June 29 to July 3
- Once water quality testing is complete, crews will begin switching water services to the temporary water supply. Water interruption notices were delivered to affected businesses on June 25, 2026.
- Excavations will begin in the north section of the project area to prepare for underground pipe replacement.
- A temporary sewer bypass system will be installed to maintain sanitary sewer service while sanitary sewer is replaced.
Work completed week of June 22 to June 26- Progress & safety: Crews located utilities, began testing the temporary watermain, and installed safety fencing to protect pedestrians and drivers.
- Road conditions: Potholes were repaired, the road was regraded, and recycled asphalt was added to improve driving through the zone.
- Traffic management: Signal timing was actively monitored and adjusted with MTO to maintain traffic flow.
Community impacts
- Access & traffic: Businesses remain open and accessible; one lane each direction is maintained, but delays are expected—plan extra travel time.
- Monitoring & scheduling: Traffic signals are being monitored/adjusted, and construction (including Canada Day work) continues to stay on schedule.
- Water service updates: Some businesses will have temporary water interruptions; notices have been delivered and the contractor will communicate directly with those affected.
-
June 22, 2026 Project Update
Share June 22, 2026 Project Update on Facebook Share June 22, 2026 Project Update on X (formerly Twitter) Share June 22, 2026 Project Update on Linkedin Email June 22, 2026 Project Update linkWork planned the week of June 22 to June 26
- Crews will test the temporary water system and begin switching water services over to it.
- Preparations will continue for upcoming underground pipe replacement work, including digging access pits.
- Utility locating work will continue to confirm the location of underground services before construction advances.
Work completed the week of June 15 to June 19
Excavation, subgrade and compaction work.- Crews focused on locating underground utilities along the corridor.
- A temporary water pipe was set up along part of King William Street to help maintain water service during construction.
- Sections of curb, asphalt, sidewalk, and landscaping were removed to allow for underground work.
- Crews began rebuilding the road base on the northbound side.
- Temporary traffic signals were installed at the Rogers Cove Drive intersection, replacing the existing signals. .
Community impacts
- Businesses in the construction zone remain open and fully accessible to customers.
- A single lane is available in each direction through the construction area. Drivers should expect delays and are asked to allow extra travel time. Traffic conditions are actively monitored, and adjustments are made as needed.
- Temporary water service disruptions are expected in the coming weeks. Advance notice will be provided before any planned interruptions, allowing residents and businesses time to prepare.
Work planned the week of June 22 to June 26
- Crews will test the temporary water system and begin switching water services over to it.
- Preparations will continue for upcoming underground pipe replacement work, including digging access pits.
- Utility locating work will continue to confirm the location of underground services before construction advances.
Work completed the week of June 15 to June 19
Excavation, subgrade and compaction work.- Crews focused on locating underground utilities along the corridor.
- A temporary water pipe was set up along part of King William Street to help maintain water service during construction.
- Sections of curb, asphalt, sidewalk, and landscaping were removed to allow for underground work.
- Crews began rebuilding the road base on the northbound side.
- Temporary traffic signals were installed at the Rogers Cove Drive intersection, replacing the existing signals. .
Community impacts
- Businesses in the construction zone remain open and fully accessible to customers.
- A single lane is available in each direction through the construction area. Drivers should expect delays and are asked to allow extra travel time. Traffic conditions are actively monitored, and adjustments are made as needed.
- Temporary water service disruptions are expected in the coming weeks. Advance notice will be provided before any planned interruptions, allowing residents and businesses time to prepare.
-
June 15, 2026 Project Update
Share June 15, 2026 Project Update on Facebook Share June 15, 2026 Project Update on X (formerly Twitter) Share June 15, 2026 Project Update on Linkedin Email June 15, 2026 Project Update link

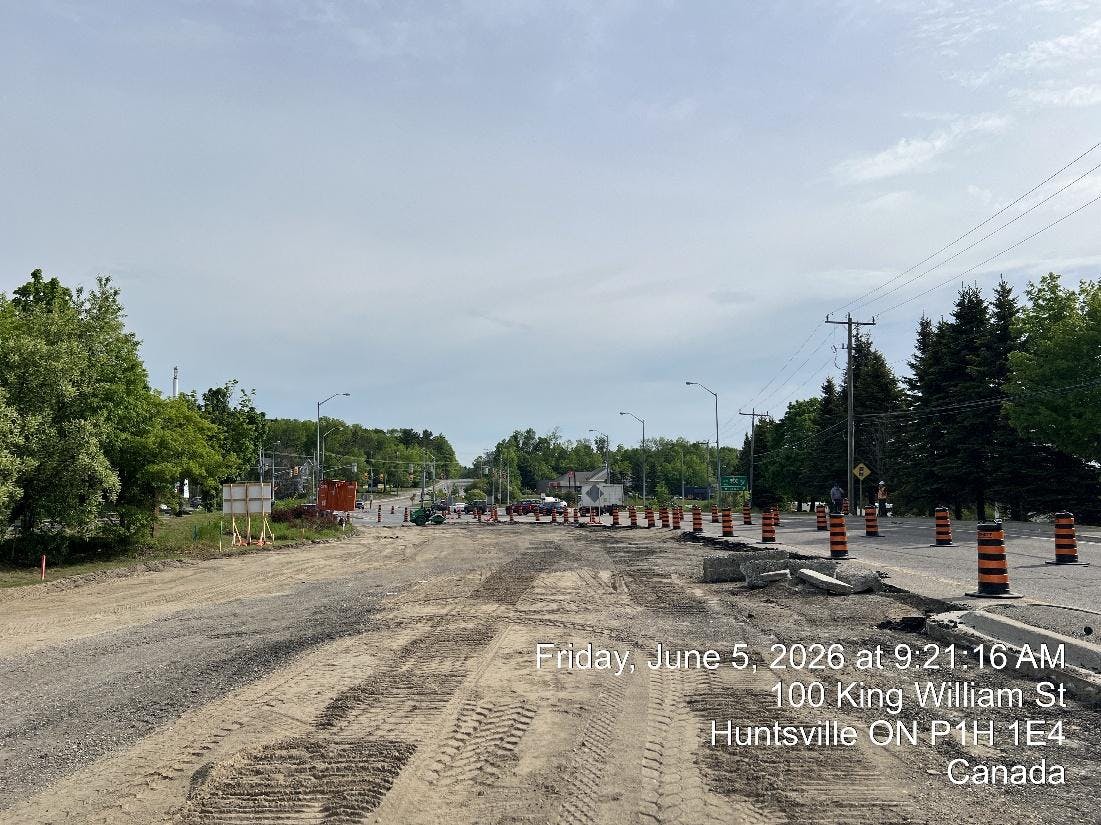

North view of project site.Work Planned: June 15 to 19, 2026- Crews will finish locating and confirming underground utilities along the corridor.
- Temporary water service will be installed. Residents and businesses will receive 10 days' notice before the temporary water main is connected.
- Depending on construction progress, crews may begin replacing the road's underlying base layers on the north side of the northbound lane. This work may also include installing new stormwater pipes and catch basins.
Work Completed: June 8 to 11, 2026
- Traffic was shifted to the southbound lane to allow work to begin on the northbound side.
- Underground utility and water service lines were located at several points along both lanes.
- Removal of the northbound lane is complete, included removing asphalt pavement, concrete curbs, traffic islands, and sidewalks.
- Temporary traffic signals for vehicles and pedestrians were installed, and the existing traffic lights were covered and taken out of service.
North view of project site.Work Planned: June 15 to 19, 2026- Crews will finish locating and confirming underground utilities along the corridor.
- Temporary water service will be installed. Residents and businesses will receive 10 days' notice before the temporary water main is connected.
- Depending on construction progress, crews may begin replacing the road's underlying base layers on the north side of the northbound lane. This work may also include installing new stormwater pipes and catch basins.
Work Completed: June 8 to 11, 2026
- Traffic was shifted to the southbound lane to allow work to begin on the northbound side.
- Underground utility and water service lines were located at several points along both lanes.
- Removal of the northbound lane is complete, included removing asphalt pavement, concrete curbs, traffic islands, and sidewalks.
- Temporary traffic signals for vehicles and pedestrians were installed, and the existing traffic lights were covered and taken out of service.
-
June 8, 2026 Project Update
Share June 8, 2026 Project Update on Facebook Share June 8, 2026 Project Update on X (formerly Twitter) Share June 8, 2026 Project Update on Linkedin Email June 8, 2026 Project Update link
Work projected between June 8 and June 12, 2026:
- Both directions of traffic will be shifted onto the southbound lane.
- Once the traffic switch is complete, removal of pavement, curbs, and sidewalks will begin on the northbound lane.
Work completed between June 1 and June 5, 2026:
- Traffic control was set up along King William Street, including closing the southbound lane and redirecting traffic to the northbound lane, maintaining one lane of travel in each direction.
- Pavement, curbs, and sidewalks were removed along the southbound lane between Rogers Cove Drive and Highway 60. Some curbs and asphalt at the King William Street and Rogers Cove Drive intersection still need to be removed.
- Traffic signal timing was adjusted to keep traffic moving smoothly, including updated turn and through-movement phases for southbound traffic.
Work projected between June 8 and June 12, 2026:
- Both directions of traffic will be shifted onto the southbound lane.
- Once the traffic switch is complete, removal of pavement, curbs, and sidewalks will begin on the northbound lane.
Work completed between June 1 and June 5, 2026:
- Traffic control was set up along King William Street, including closing the southbound lane and redirecting traffic to the northbound lane, maintaining one lane of travel in each direction.
- Pavement, curbs, and sidewalks were removed along the southbound lane between Rogers Cove Drive and Highway 60. Some curbs and asphalt at the King William Street and Rogers Cove Drive intersection still need to be removed.
- Traffic signal timing was adjusted to keep traffic moving smoothly, including updated turn and through-movement phases for southbound traffic.
-
June 3, 2026 Project Update
Share June 3, 2026 Project Update on Facebook Share June 3, 2026 Project Update on X (formerly Twitter) Share June 3, 2026 Project Update on Linkedin Email June 3, 2026 Project Update linkKing William Street Reconstruction Update: Two-Way Traffic to be Maintained During Construction
The District of Muskoka has revised its traffic management plan for the King William Street reconstruction project and will maintain one northbound lane and one southbound lane through the construction area while work progresses.
The original plan called for King William Street to operate as one-way southbound traffic only between Scott Street and Highway 60. Following discussions with local businesses, the District worked with the contractor to review the traffic management plan and identify a solution that would maintain two-way access through the construction zone.
To support this revised approach, additional traffic control measures will be implemented, including temporary signal modifications, additional traffic control staff, and specialized traffic control equipment.
What to Expect
- One northbound lane and one southbound lane will be maintained through the construction area.
- Lane closures are anticipated to begin this week once traffic control measures are finalized.
- Access to all businesses will be maintained throughout construction.
- Significant traffic delays and congestion are expected in both directions during contractor hours, particularly Monday through Thursday
- Traffic conditions are expected to improve during evenings and weekends when construction activities are reduced or paused.
- Motorists are encouraged to allow extra travel time and consider alternative routes where possible.
The District and its contractor will continue to monitor traffic conditions and project operations throughout construction and make adjustments where practical and appropriate.
The District appreciates the feedback received from local businesses and remains committed to working collaboratively with the community throughout construction.
King William Street Reconstruction Update: Two-Way Traffic to be Maintained During Construction
The District of Muskoka has revised its traffic management plan for the King William Street reconstruction project and will maintain one northbound lane and one southbound lane through the construction area while work progresses.
The original plan called for King William Street to operate as one-way southbound traffic only between Scott Street and Highway 60. Following discussions with local businesses, the District worked with the contractor to review the traffic management plan and identify a solution that would maintain two-way access through the construction zone.
To support this revised approach, additional traffic control measures will be implemented, including temporary signal modifications, additional traffic control staff, and specialized traffic control equipment.
What to Expect
- One northbound lane and one southbound lane will be maintained through the construction area.
- Lane closures are anticipated to begin this week once traffic control measures are finalized.
- Access to all businesses will be maintained throughout construction.
- Significant traffic delays and congestion are expected in both directions during contractor hours, particularly Monday through Thursday
- Traffic conditions are expected to improve during evenings and weekends when construction activities are reduced or paused.
- Motorists are encouraged to allow extra travel time and consider alternative routes where possible.
The District and its contractor will continue to monitor traffic conditions and project operations throughout construction and make adjustments where practical and appropriate.
The District appreciates the feedback received from local businesses and remains committed to working collaboratively with the community throughout construction.
-
Click here to play video Why King William Street Construction Is Necessary King William Street's under construction to replace decades-old water pipes. Aging sewer and stormwater systems are being upgraded at the same time. Supported by Ontario's Housing-Enabling Water Systems Fund, this work is an investment in new homes, local businesses and our growing community by building infrastructure that will serve Huntsville for generations to come.
- Where is construction taking place?
- Why is this project happening?
- How long will construction take?
- What can I expect during construction?
- Will work take place at night?
- Will pedestrians have access?
- Will businesses remain open during construction?
- What is a Construction Café?
- Who can I reach out to for more information?
-
March 2026
King William Street Reconstruction has finished this stageTender awarded
-
June 2026
King William Street Reconstruction is currently at this stageConstruction starts
-
By the end of 2026
this is an upcoming stage for King William Street ReconstructionProject completion
-
On-site Construction Public Relations (Look for the green hard hat)
BBPhone 705-627-6051 Email KingWilliamPR@arnottgroup.com -
